How long a website takes to build, and what moves the deadline

Where the weeks actually go on a marketing or property website, which stages cannot be compressed, and the three client-side habits that push launch dates back.

Why "how long will it take" is the wrong opening question

A number on its own tells you nothing. The same "site in a month" can mean a template with swapped photos or a landing page built around your own argument. The useful question is what the number is made of — that is where you see whether a deadline is real or a sales answer that will slip in week two.

We quote by stage, and each stage has a floor below which work does not speed up, it just gets worse.

Where the weeks go

Structure and wireframes — one to two weeks. This is where you decide what a visitor sees and in what order they get the argument. It is the cheapest stage to change and the most expensive to get wrong: moving a block on a wireframe takes minutes, moving the same block after build takes a day.

Design — two to four weeks. Driven by the number of distinct screens, not the number of pages. A two-hundred-item catalogue is two layouts, not two hundred. A landing page with seven unlike sections is seven separate decisions.

Build — from a week and a half. Markup, assembly, forms, analytics. The number grows with integrations: every external system means agreeing a format, getting credentials and handling the case where it goes quiet. Why we build on code rather than a builder is covered in Next.js versus website builders.

Content — parallel, but not free. Copy, photography, specifications. On paper it runs alongside design. In practice it is the single most common reason a project stalls: the layouts are ready and there is nothing to put in them.

What actually moves the date

In our projects deadlines are rarely lost in design or build. They are lost in three places, all of them on the organisation side.

Diffuse sign-off. When five people review a layout and each sends notes separately, every review round doubles. The working arrangement is one owner who collects opinions internally and brings back a single decision.

"We'll send the content later." The most common cause of dead time. We put the required materials and their due dates into the brief up front. If the substance is not there, moving the start is more honest than designing around placeholders and redoing it later.

Late scope changes. Adding a section during design costs days. Adding the same section after build costs a week, because everything around it has to be reassembled. That is not a contractor being difficult; it is how the work stacks.

The quiet time sinks

Three things eat weeks without anyone noticing until the end.

Credentials. Domain, hosting, mail, CRM, inventory system — each has an owner, and the owner is rarely in the thread on day one. Requesting access belongs in week one of the plan, not the week it is needed.

Legal copy. Privacy policy, terms, company details. Half a page of text and a lawyer with their own queue. The site cannot go live without it, and it is regularly the last open item.

Photography. A shoot has its own schedule: the location, the weather, the people, the retouching. If the project depends on original images, book the date at the start, not when the layouts are waiting.

Rough figures

  • Single-project or product landing page — four to five weeks.
  • Corporate or manufacturer site — six to eight weeks.
  • Online store — from eight weeks, then it depends on catalogue and integrations.
  • Property sales site with unit selection — from ten weeks, and most of it is data.

These assume the substance is ready and one person on your side can decide. We fix the estimate and the date before we start: if our own estimate slips, that is our problem, not a reason to invoice more.

Three questions for any contractor

Ask what stages the number is made of, what has to be ready on your side and by when, and what happens to the date if your feedback arrives a week late. A clear answer to the third question is what separates a plan from a promise.

Questions

How long does a single landing page take?

Four to five weeks from kickoff to launch when the content is ready. A week on structure and wireframes, two on design, a week and a half on build and QA. Anything faster than two weeks means a template with your photos in it, which is a different service at a different price.

Why does a project website take ten weeks and not three?

Because most of the time goes into data, not screens. The unit list, statuses, prices, floor plans and the CRM handoff all have to be agreed, formatted and tested. Drawing the selector is quick; agreeing where the site reads live availability from is not.

Can we pay to go faster?

Partly. Adding designers shortens the design stage. It does nothing for approvals or content gathering, which is where most delays live. The fastest projects are the ones with a single decision-maker on the client side.

What happens after launch?

Two to three weeks of stabilisation: fixes against real traffic, analytics tuning, small adjustments. After that either ad-hoc tasks or a monthly retainer if the site keeps developing.

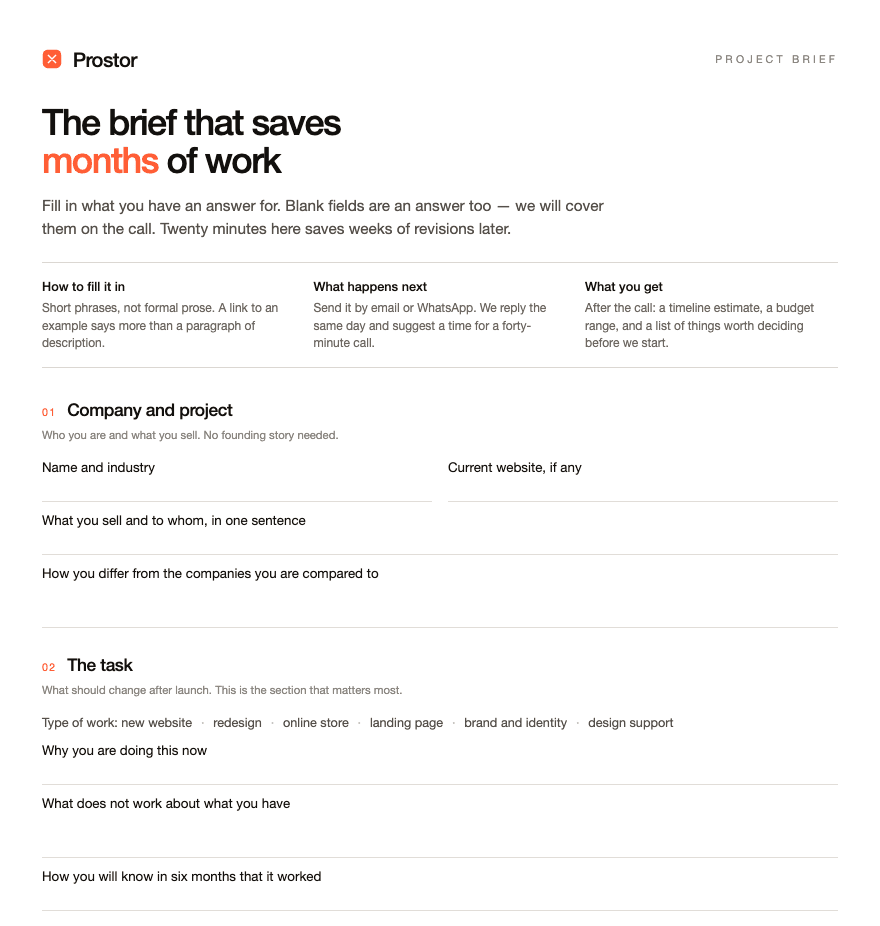

First page of the Prostor project brief template
Resource

Project brief template

The same document we send clients before we start. Seven sections, about twenty minutes to fill in, and it removes half the questions from the first call.

What is inside
  • Company and project
  • The task and what success looks like
  • Who buys
  • What the site needs
  • Timeline, budget, constraints
  • Taste and examples
  • Materials and sign-off
PDF · 3 pages · fill it in by hand or in any editor

Tell us the task in four answers

Answer with the buttons or in your own words — that is enough for us to come to the call with thoughts instead of generic questions.

Ruslan Kochubarov
Ruslan Kochubarov
Founder, art director

Tell us about the task

Book a 30-minute call or leave a request — we reply within 30 minutes during working hours and send a brief and relevant examples.

Book a call

Projects from $3,000 · ongoing support from $1,500/mo

  1. Reply within 30 minutes
  2. A 30-minute call
  3. A scoped estimate
